Bought as one, let as two.
Eight contractors, 155 transactions and 50+ inspections, run against one budget and a fixed move-in date.
A retrospective PRINCE2 (7th edition) review.
The brief
This project followed straight on from a restaurant acquisition that did not complete. The capital was ready, and the aim was a sound rental investment.
The strategy: sum-of-the-parts value. When a property is priced as one unit but the market wants two, splitting it releases the difference. Here, the previous owner had merged two semis into one seven-bedroom house. Few tenants want seven bedrooms, and the price showed it: about 20% less per bedroom than a three-bed semi sold on the same street this year. Split back into a three-bed and a four-bed, it would match local demand. Execution risk was low: the original floor plans were almost intact, so the split required zero structural work and about £27k*. The test was whether two homes would be worth more than one.

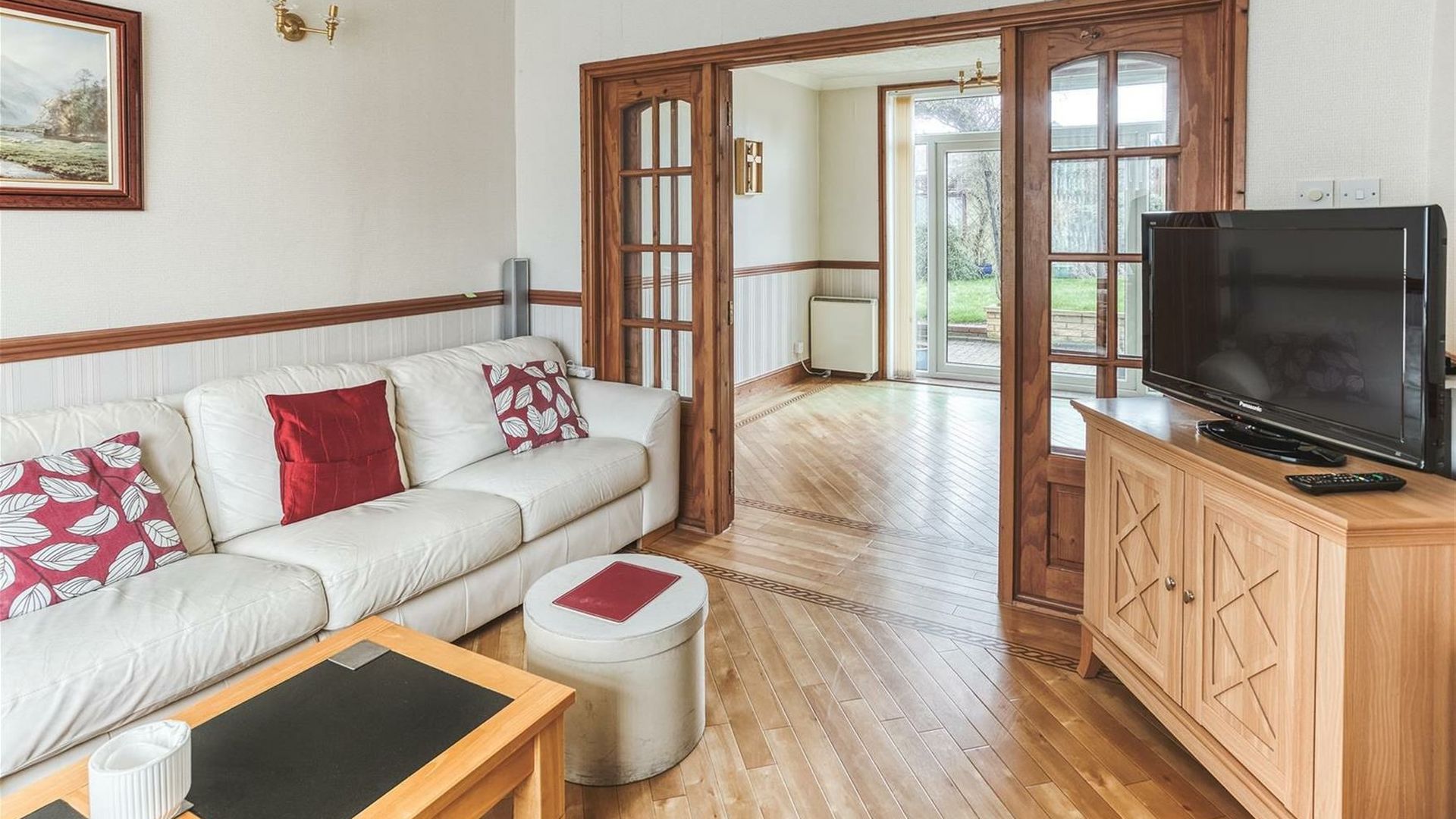

- 1Connecting door through the middle wall: sealed.

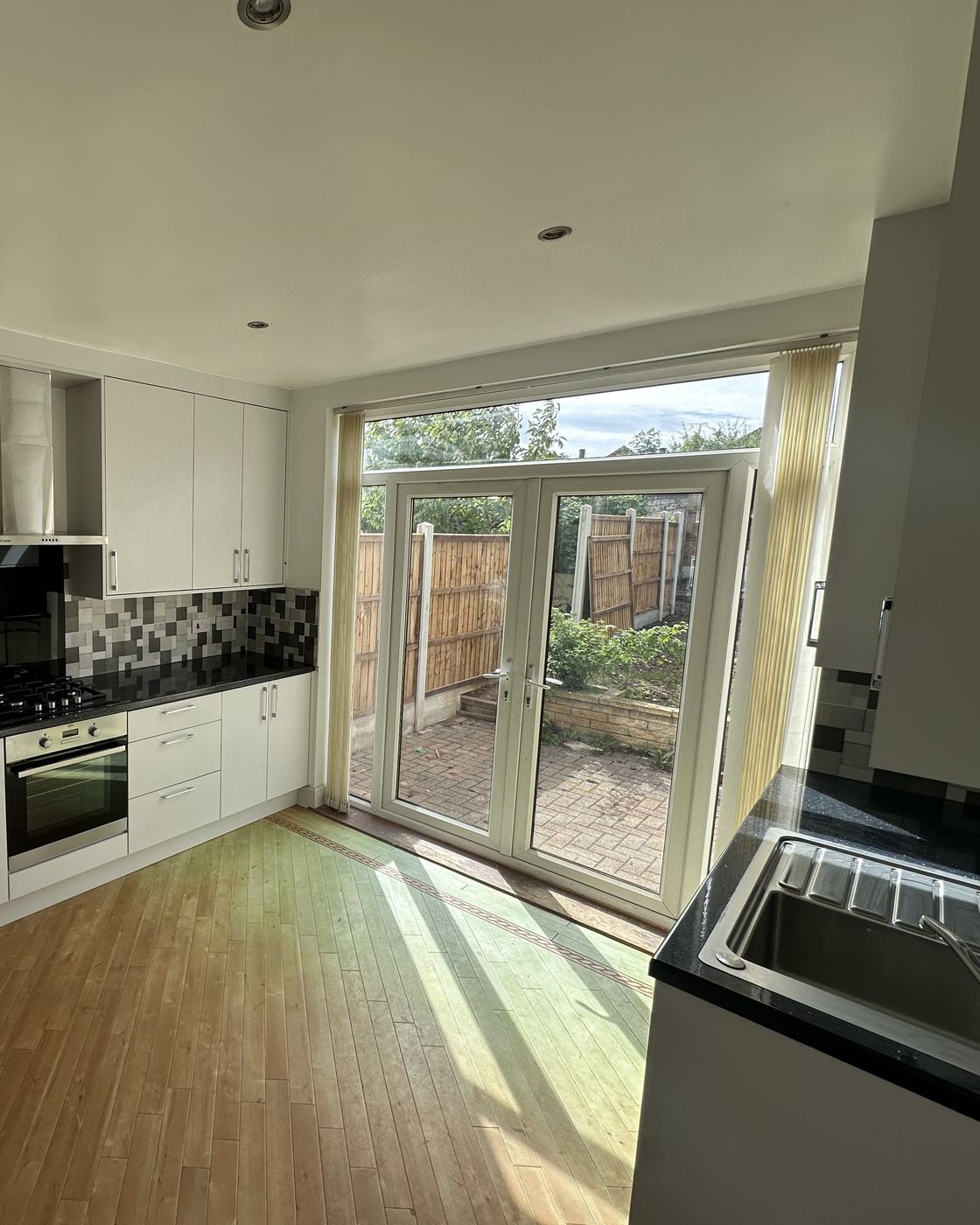

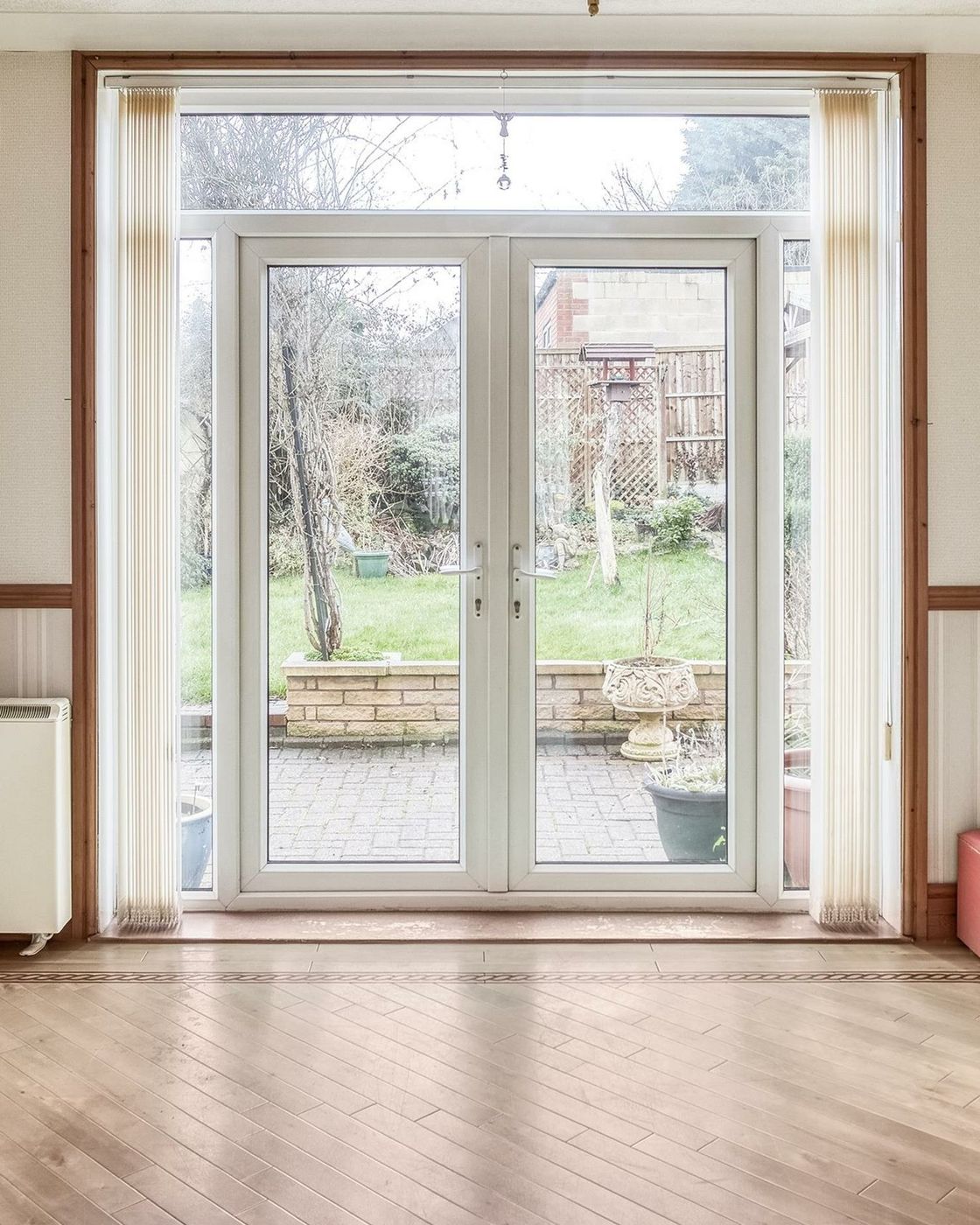

- 2Dining room fitted out as the four-bed's kitchen.
- 3Shared landing closed. Front bedrooms enlarged.
- 4Ensuite turned into the main family bathroom for the three-bed.
- 5Garden divided in two.

Floor plans
Stages
Search
Aug to Sep 2025Five to ten properties viewed, including apartments, HMOs and uninhabitable development opportunities.
Ended withOffer accepted, 19 Sep 2025
Purchase and planning
Sep 2025 to Jan 2026Finance and legal work. Floor plan marked up, two trade quotes fixed, the rest priced by estimate.
Ended withPurchase completed, 16 Jan 2026
Home 1, three-bed
16 Jan to 1 Mar 2026Rewire and gas supply for both homes. Three-bed fitted out in full.
Ended withLet 1 Mar 2026, £1,200 pcm
Home 2, four-bed
Mar to Sep 2026Same finish, leaner labour. Works complete in August.
Ended withLet 4 Sep 2026, £1,500 pcm
The delivery
Seven practicesWhy this house
This house had a sound structure and a split that was an easy fix. It was one of five to ten properties viewed, and each of the others fell short. Ready-to-let homes cost more and yielded less. One was uninhabitable: its first floor was in poor shape and needed expensive structural work. An HMO came with management costs we wanted to avoid. The other option for this house was to let it whole to one group of seven: a good yield, but thin demand and reliance on one group. The split was chosen for long-term demand.
| Measure | Expected | Actual |
|---|---|---|
| Refurbishment and letting cost | £20k to £25k* | about £27k* |
| Combined rent | £2,500 pcm | £2,700 pcm |
| Three-bed let | within two weeks of the works finishing | the day after |
| Four-bed let | about a month after the works | three to four weeks* |
Who decided what
Run alongside a full-time role. Every major job went to two or three quotes.
What changed
Walls needed more work than expected
- Effect
- Two to three days and £1k to £2k* added
- Decision
- Refinished throughout, to the same standard. Agreed with the other investors first.
A better kitchen than planned
- Effect
- Scope and cost grew
- Decision
- Newly fitted kitchen chosen over a cheaper option. Agreed and paid for.
Fixed move-in date for the three-bed
- Effect
- Overtime, and more of the budget
- Decision
- Held 1 March. The tenants were leaving their previous home that day.
Plaster finish had defects
- Effect
- The plasterers came back twice
- Decision
- Every defect marked with bright tape and listed, until the list was clear.
No gas supply on one side
- Effect
- No boiler or radiators until it was in
- Decision
- New supply requested on day one.
The standard
I agreed the standard with each trade before work began. The electrician worked to exact socket positions and heights, and to where each appliance would sit. The plaster finish was agreed up front, then checked wall by wall.

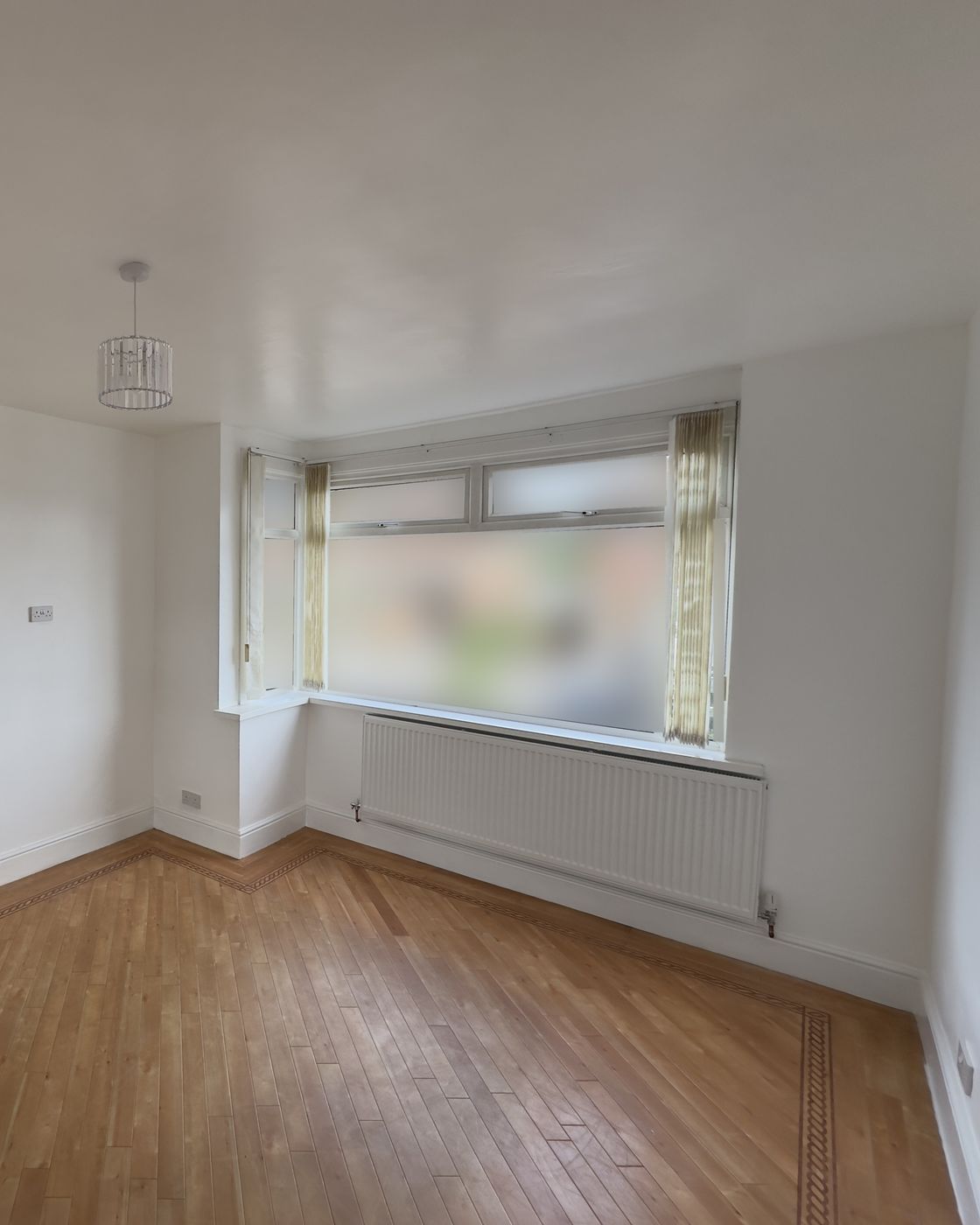

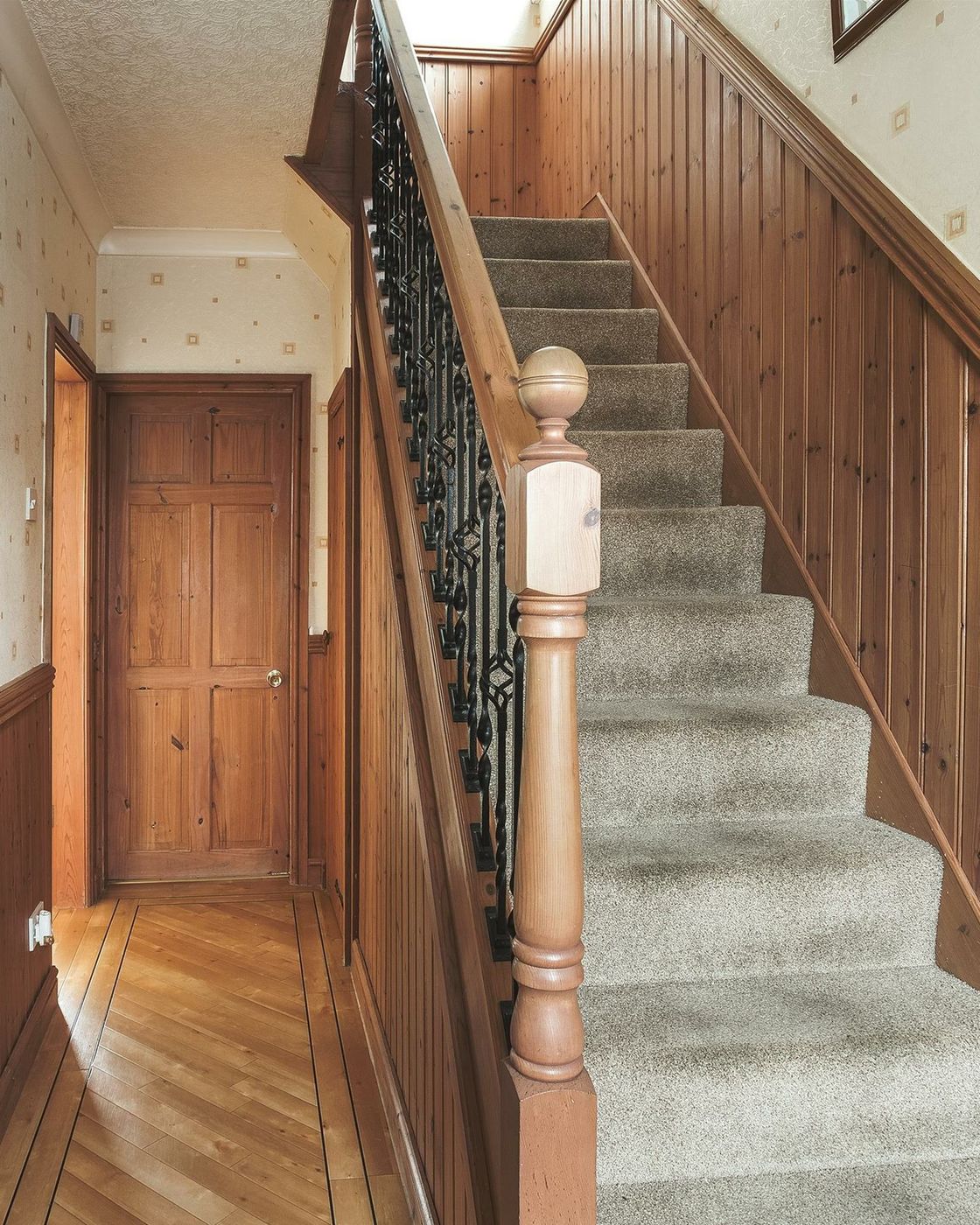

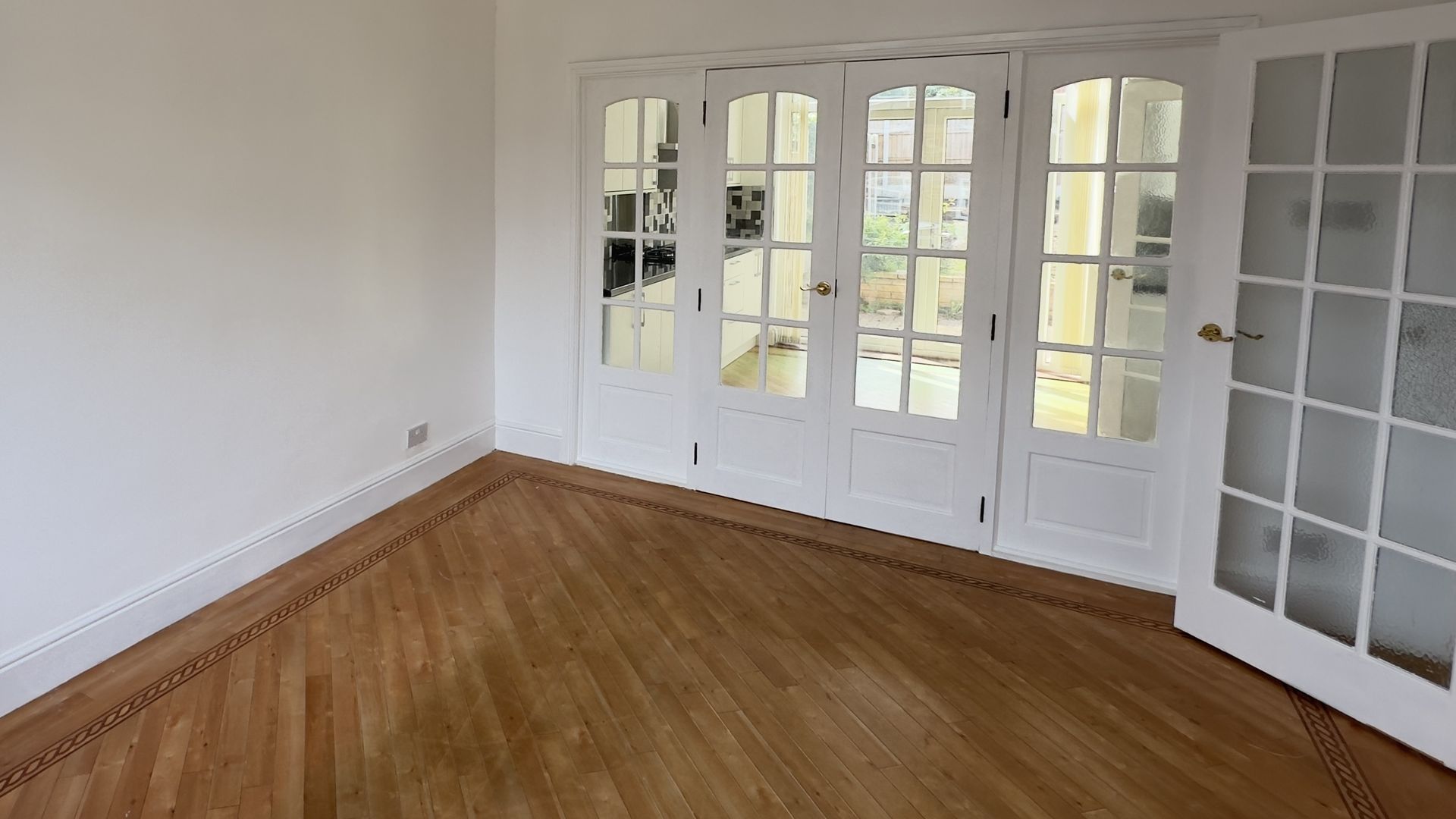

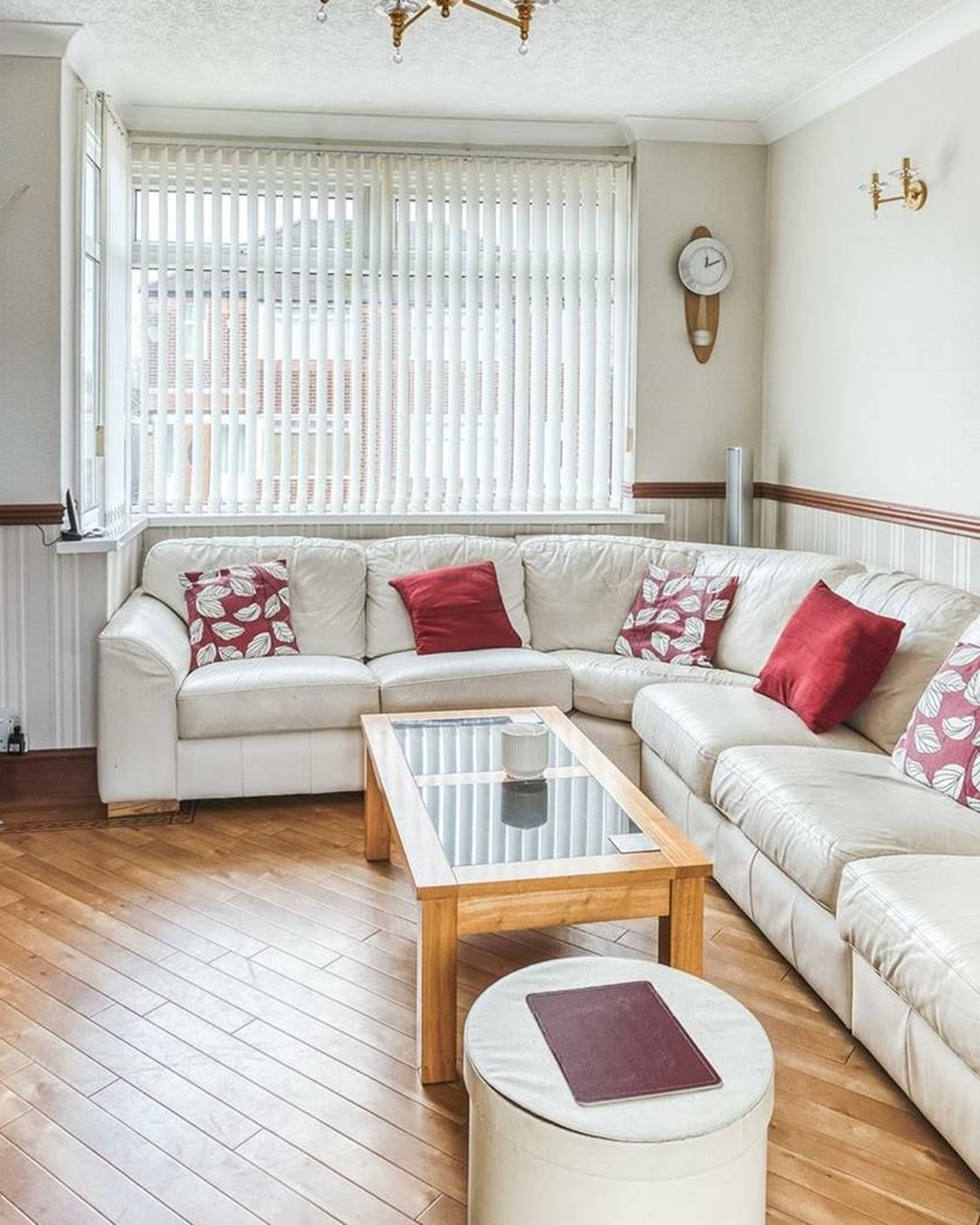

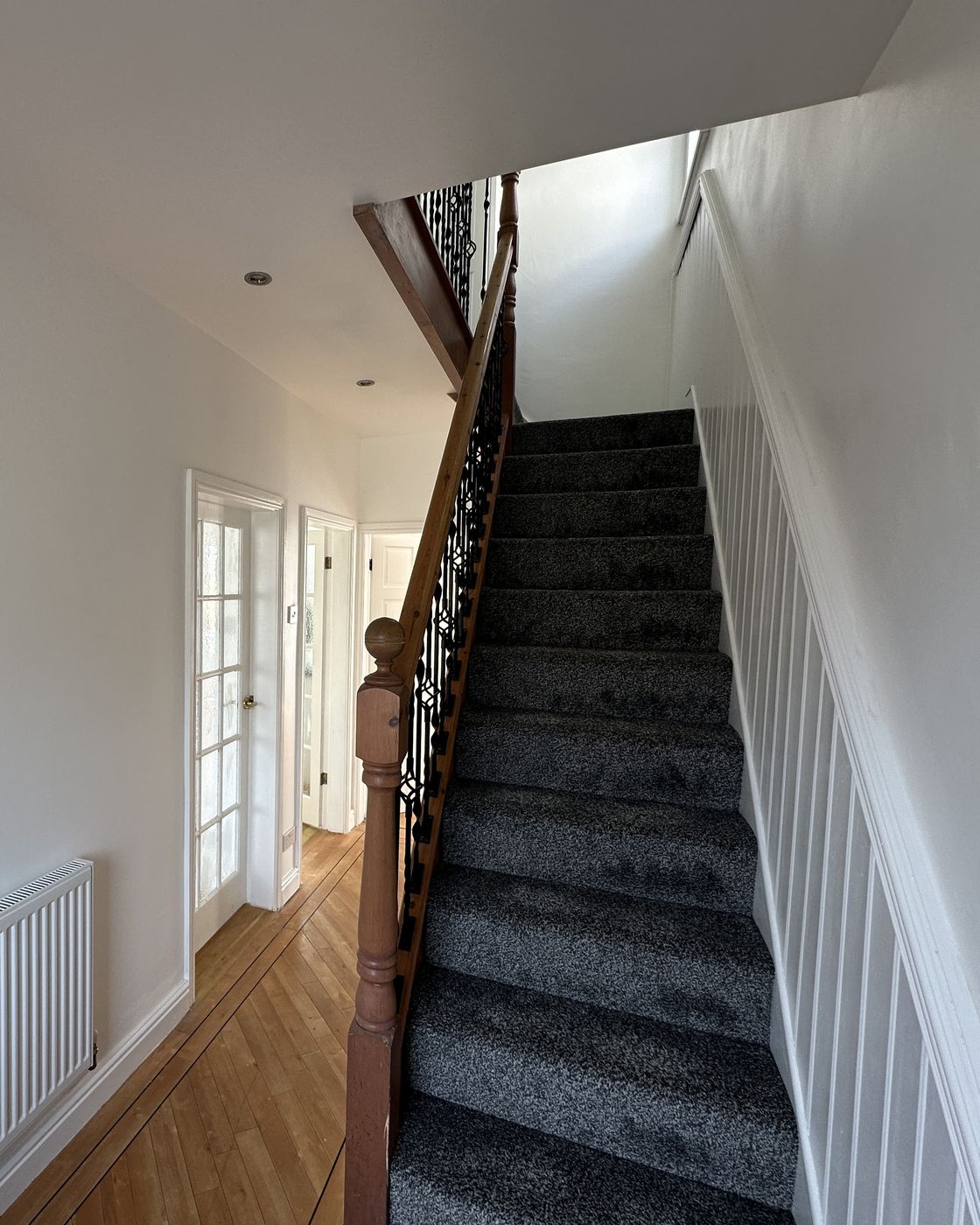

Keep what works, replace what doesn't. Original parquet, staircases and joinery stayed. Carpets, decoration and the four-bed's kitchen were new. Spend went where tenants look first.
All works were completed to meet certification standards.

The sequence
The run above was done twice: the three-bed first, then the four-bed. Shared work, such as the electrical and heating splits, ran across both.
The plan lived on a marked-up floor plan showing walls, door frames and socket positions, and in a buying list. Materials for both homes were bought in bulk, ahead of need.
The three-bed used day-rate labour. The four-bed used far less, with more of my own work. The finish matched, and the works ran to August.
What could go wrong
| Risk | What I did | What happened |
|---|---|---|
| Hidden structural problems | Thorough viewings before buying. The original floor plan was almost intact. | AvoidedZero structural work |
| No tenants | Started looking during the works, by word of mouth | AvoidedBoth let with no agent and no listing. |
| Rent below target | Early tenant conversations tested the rent | AvoidedAbove target |
| Costs running over | Budget set as a range, with about £5k* held for surprises | LandedAbout £27k* against £20k to £25k*: the walls and the kitchen took it past |
| Trades holding each other up | Each dependent trade given a start window of two or three days | HeldThe three-bed was ready for 1 March |
Where the money went
Refurbishment and letting
Cash payments were written down as they were made. Card payments were tracked from the bank records. After the works, every record went into one workbook.
Close
Outcome
Estimates*: combined value £550k*, professional valuation pending. Yield on developed value 5.9%*.
What I'd keep
The method, tested on this first build: buy a high-yield property with room for an uplift, refurbish to release it, refinance, then hold and let where that makes sense. Each project can fund the next.
What I'd change
Two things. Finance the build with short-term development lending and bring in a mortgage at the refinance point. And write the plan down in stages, so the project does not rest on my memory. That is what PRINCE2 adds, tailored: light documents for a small project, but some.
Follow-on
Both homes are held and let. A professional valuation comes next, then a refinance. One contractor balance is still to close. The four-bed alone has a 100+ photo check-in inventory.
Figures marked * are estimates. All others are confirmed.
